Enterprise AI Consulting Services: What to Expect from an Engagement

AI/ML
28 May, 2026
Enterprise AI Consulting Services: What to Expect from an Engagement

What does an enterprise AI consulting engagement involve? A credible enterprise AI consulting engagement in 2026 moves through four phases: discovery (understanding the business problem, assessing data readiness, and identifying the highest-ROI use case), architecture and scoping (designing the technical approach and defining measurable success criteria before any development begins), development and deployment (building and deploying a production-grade AI system with proper access controls, monitoring, and governance), and knowledge transfer and handover (ensuring the client organisation can operate and evolve the system independently after the engagement closes). A consulting engagement that spends more than 60 days in assessment without delivering working software is a red flag.

How much does enterprise AI consulting cost in 2026? Enterprise AI consulting costs vary significantly by firm tier and scope. Boutique and specialist AI consulting firms typically charge $100 to $300 per hour, with first production deployments running $80,000 to $200,000. Global consulting firms (McKinsey, BCG, Accenture, Deloitte) charge $300 to $600 per hour, with elite strategy partners billing up to $900 per hour (Fortune, 2025), and engagement minimums typically starting at $500,000. The global AI consulting services market reached approximately $14 billion in 2026 and is projected to grow at a 26% CAGR through 2035, distinct from the broader $115 billion enterprise AI market that includes software, infrastructure, and services. A well-scoped first engagement with a specialist mid-market firm typically runs $80,000 to $200,000 for a production-ready first deployment, with the target that AI solutions should save or generate at least 3x the engagement cost within the first 12 months.

The global AI consulting services market reached approximately $14 billion in 2026, growing at 26% annually, part of a broader enterprise AI market valued at $115 billion. 78% of organisations now use AI in at least one function. Yet McKinsey’s 2026 State of AI report found that only the top 6% of organisations those attributing 5% or more of EBIT impact to AI   are extracting genuine strategic value. A 2026 McKinsey analysis put the ROI failure rate at 73%. And 56% of CEOs in PwC’s 2026 Global CEO Survey said they had “gotten nothing out of” their AI investments.

These numbers describe an industry where investment is high, results are variable, and accountability is scarce. Many enterprises have spent significant budget with AI consultants and have little to show for it beyond a strategy document and a proof of concept that never reached production. Many others have achieved genuine operational value from well-structured engagements with credible partners.

The difference is almost entirely in how the engagement was designed, scoped, and held accountable – not in which AI technology was used.

This guide tells you what an enterprise AI consulting engagement should look like in 2026: what phases it moves through, what deliverables you should receive at each phase, what the pricing landscape looks like across different firm types, the red flags that indicate a consulting relationship that will not deliver, and how to structure the accountability conversation from day one to ensure you get the 3x ROI that a well-executed engagement should produce.

The Consulting Landscape: What Kind of Firm Are You Hiring?

The enterprise AI consulting market in 2026 is broad and heterogeneous. Understanding where different firm types sit helps you match the right engagement model to your specific needs.

Global consulting firms (Accenture, Deloitte, McKinsey, BCG, KPMG, EY) offer strategic advisory, industry benchmarking, AI maturity assessments, and implementation capability. Their strengths are C-suite credibility, regulatory expertise across multiple industries, and the ability to manage complex multi-region programmes. Their limitations are minimum engagement sizes (typically $500,000 or more), slower execution pace, and implementation teams that may be less experienced than the senior partners who won the engagement. They are best for organisations that need board-level AI strategy before deciding what to build, or that require a firm with the brand credibility to drive cross-functional organisational change.

Cloud provider professional services (AWS, Microsoft Azure, Google Cloud) offer AI implementation services tied to their cloud ecosystems. Their strength is deep integration with their own tooling and preferential pricing on platform services. Their limitation is inherent bias toward their own technology stack – a Microsoft professional services team will build on Azure regardless of whether that is the right choice for your specific requirements.

Specialist AI consulting and engineering firms occupy the most productive middle ground for most mid-market enterprise engagements. They combine strategic advisory capability (helping you define what to build and why) with genuine engineering execution (actually building and deploying the AI system). The best firms in this category have shipped production AI systems – not just delivered strategy decks or proof-of-concept demos – and can demonstrate measurable client outcomes from those deployments. Blended rates at specialist boutiques typically run $100 to $200 per hour, with first production deployments ranging from $80,000 to $200,000, materially lower than global firm rates for equivalent or better engineering execution.

Pure engineering firms and offshore development teams build AI systems to specification, but typically do not have the advisory capability to help you determine what to build in the first place. They are the right choice when you have a precise, technically defined requirement and need cost-effective engineering execution. They are the wrong choice when you need help defining the problem before solving it.

Moweb operates as a specialist AI consulting and engineering firm with global delivery capability: strategy and use case definition combined with end-to-end engineering delivery, ISO 27001:2022 certified and CMMI Level 3 compliant, with offices in Secaucus, New Jersey, and Ahmedabad, India.

What a Credible Engagement Looks Like: Four Phases

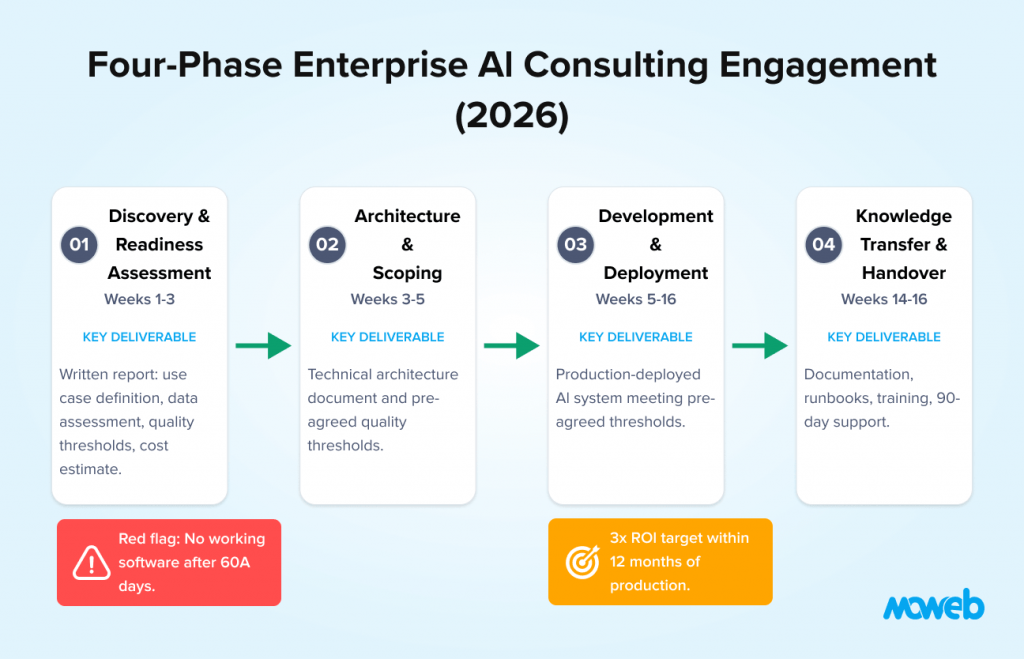

Four phase enterprise ai consulting roadmap including discovery architecture deployment and knowledge transfer

A well-structured enterprise AI consulting engagement moves through four distinct phases. Understanding each phase helps you evaluate proposals, set expectations, and hold your partner accountable at each milestone.

Phase 1: Discovery and Readiness Assessment (Weeks 1 to 3)

The discovery phase is where the engagement earns its value – or wastes it. A discovery phase done properly surfaces the most consequential information about your AI programme before any significant engineering investment is made.

A credible discovery phase covers:

Business problem definition. What specific operational problem is the AI system solving? For whom? How is it currently being solved? What does success look like in measurable terms? A consulting firm that accepts a vague brief (“improve customer experience with AI”) without pressing for specificity is a consulting firm that will deliver a vague solution.

Data readiness assessment. Does the data required for the proposed use case exist? Is it accessible? Is it clean enough to be useful? This is where most AI projects encounter their first major surprise. A 2025 MIT Sloan study found that 61% of enterprise AI projects were approved based on projected value that was never formally measured after deployment, often because the data reality discovered mid-project invalidated the original business case. A discovery phase that does not include a genuine data quality assessment is not complete.

Technical feasibility evaluation. Given the data reality and the business problem, is the proposed AI approach technically viable? What are the key architectural risks? What assumptions need to be validated in a PoC before committing to a full build?

Use case prioritisation. If multiple AI use cases are under consideration, which should come first based on ROI potential, data readiness, and risk profile?

Deliverable: A written discovery report covering the use case definition, data assessment findings, proposed technical approach, success criteria, engagement scope, timeline, and investment estimate for the next phase. This document is the foundation of everything that follows. If a consulting firm cannot produce a clear, specific discovery report within three weeks, that is a signal about their delivery quality.

Phase 2: Architecture and Scoping (Weeks 3 to 5)

With the discovery findings validated, the architecture phase designs the technical system before development begins. This is the phase that prevents the most expensive mistakes in AI development.

A credible architecture phase produces:

Technical architecture documentation covering the AI system components (data pipeline, model/retrieval layer, integration points, access controls, monitoring), the tooling selections and their rationale, the security and governance design, and the deployment architecture.

Pre-agreed quality thresholds – the specific metrics that will be used to evaluate whether the AI system has met its objectives. These thresholds must be agreed upon before development begins, not negotiated after the system is built. “We will evaluate retrieval quality using RAGAS and target a faithfulness score above 0.85 on a test set of 100 representative queries” is a pre-agreed quality threshold. “We’ll know it’s working when it feels right” is not.

Revised cost and timeline estimate based on the architecture decisions. A discovery phase typically produces a range estimate. The architecture phase, with a defined technical approach and agreed scope, should produce a more specific estimate with defined contingency for the identified technical risks.

Deliverable: Technical architecture document, pre-agreed quality thresholds, and revised project plan. The architecture document should be specific enough that a separate engineering team could build from it – if it is too vague for that standard, ask for more detail.

Phase 3: Development and Deployment (Weeks 5 to 16)

The development phase is where the system is built, tested, and deployed to production. A credible development phase has specific characteristics that distinguish it from a prototyping exercise.

It builds for production, not for demo. Access controls, audit logging, error handling, monitoring, and graceful failure behaviour are built in from the start, not added after the core functionality is working. A system that works correctly on clean test inputs but lacks production-grade engineering is a prototype, not a deliverable.

It measures against the agreed quality thresholds. The evaluation framework defined in Phase 2 is applied to the built system on representative real data before the phase is considered complete. A consulting firm that delivers a system and asks you to approve it without a structured evaluation against pre-agreed metrics is avoiding accountability.

It produces working software at defined milestones. A day-30 milestone should produce a working system in a staging environment with real data flowing through it. A day-60 milestone should produce a staging environment ready for user acceptance testing. A consulting firm still in “assessment” or “design” mode after 60 days is a red flag.

It includes integration in scope, not as an afterthought. The AI system must be connected to the enterprise systems it needs to access and act within. Integration is frequently where AI projects underestimate complexity and overrun timelines. A credible engagement identifies integration complexity in Phase 2 and plans for it in Phase 3, rather than treating it as a discovery at implementation time.

Deliverable: A production-deployed AI system meeting the pre-agreed quality thresholds, with complete technical documentation, operational runbooks, and an acceptance sign-off against the success criteria defined in Phase 2.

Phase 4: Knowledge Transfer and Handover (Weeks 14 to 16)

The knowledge transfer phase is the most frequently neglected and the one that determines whether your organisation can sustain value from the AI system after the consulting engagement closes.

A credible knowledge transfer covers:

Technical documentation that enables your engineering team to operate, maintain, and extend the system: architecture diagrams, configuration documentation, data pipeline descriptions, model or retrieval pipeline design decisions and their rationale, and monitoring setup.

Operational runbooks that enable non-engineering operations teams to manage routine system health: how to identify and respond to quality degradation alerts, how to initiate re-indexing when the knowledge base is updated, how to escalate incidents, and who to contact for different categories of issues.

Team training sessions covering how the system works at a conceptual level (for business stakeholders), how it is operated and monitored (for the operations team), and how it can be extended or modified (for the engineering team).

Post-engagement support commitment defines the consulting firm’s availability for questions and minor issues after the formal engagement closes. The absence of a defined support commitment is a practical statement that the firm considers its obligations complete at handover, regardless of what problems emerge in the first weeks of independent operation.

Deliverable: Complete technical documentation package, operational runbooks, recorded or live training sessions, and a defined post-engagement support arrangement.

Pricing: What Enterprise AI Consulting Actually Costs

Enterprise ai consulting pricing comparison showing hourly rates deployment costs and consulting firm types

Pricing transparency is one of the most consistent complaints enterprises have about AI consulting firms. Here is an honest breakdown of what different types of engagements cost in 2026.

Discovery and assessment only: $15,000 to $40,000 for a focused 3-week discovery covering one or two use cases, data assessment, and architecture recommendation. This is the right entry point for organisations that need to validate their AI investment thesis before committing to a larger engagement.

PoC or pilot build: $30,000 to $80,000 for a 6 to 10 week focused proof-of-concept demonstrating core AI capability on real data. For what these should include and what makes a PoC genuinely useful versus just impressive, see our guide to what an AI proof of concept costs in 2026.

First production deployment (specialist firm): $80,000 to $200,000 for a full discovery-to-production engagement, including data engineering, AI system build, integration, governance, and knowledge transfer. This range covers a focused single-use-case deployment with one or two primary integrations.

First production deployment (enterprise consulting firm): $500,000 to $5,000,000 for the equivalent scope, reflecting the overhead structure, pyramid billing model, and day rates of global consulting firms. The quality of output is not necessarily proportional to the price differential at Big 4 rates; a meaningful portion of billing goes to project governance and documentation overhead rather than engineering execution.

Ongoing operations and optimisation retainer: $5,000 to $20,000 per month for specialist firms, covering monitoring, quality maintenance, model updates, and enhancement work on a running system. Budget an additional 20–40% above the consulting fee to cover infrastructure, API costs, internal staff time, and support a common omission from initial proposals.The ROI target that a credible consulting firm should be willing to commit to: AI solutions should save or generate at least 3x the engagement cost within the first 12 months of production operation. McKinsey’s 2025 State of AI survey recorded a 5.8x average ROI on AI investment within 14 months of production deployment for well-executed programmes, but also found that only the top 6% of organisations are achieving this level of return. The distinguishing factors were not technology choices but organisational practices: redesigning workflows, scaling faster, embedding AI into business processes, tracking KPIs, and having senior leadership directly committed to outcomes. A firm that is unwilling to project or discuss ROI targets during the engagement design phase is not confident in its own work.

Red Flags That Should End the Conversation

The following patterns appear consistently in AI consulting engagements that do not deliver. Encountering two or more of them in a vendor evaluation should prompt serious reconsideration.

No working software by day 60. An engagement still in strategy, assessment, or design mode after two months is billing you for overhead rather than delivering value. The assessment should produce a document in weeks 1 to 3. After that, the development phase should be underway. Two months of “assessment” is not diligence; it is a billing model. S&P Global’s 2025 survey found that 42% of companies abandoned most AI initiatives before production, a rate that increased from 17% in 2024. The primary driver was pilot programmes that could not demonstrate a credible production pathway after months of engagement. should be underway. Two months of “assessment” is not diligence – it is a billing model.

Vague deliverables in the proposal. “AI strategy framework,” “AI readiness report,” and “GenAI roadmap” are not deliverables in the sense that matters. Running code deployed to a staging environment is a deliverable. A specific, documented architecture with pre-agreed quality thresholds is a deliverable. A proposal that cannot describe what it will deliver in concrete, measurable terms should not be signed.

Model obsession over business problem definition. If a consulting firm spends more time discussing which LLM to use (GPT-4o versus Claude 3.5 versus Gemini) than understanding your specific business problem, data environment, and success criteria, they are optimising the wrong thing. The model is the least important decision in most enterprise AI projects. The data, the architecture, the integration, and the governance are what determine outcomes.

No cost projection for ongoing operations. AI systems have ongoing costs: LLM API fees, vector database hosting, monitoring tooling, and engineering time for maintenance and updates. A consulting firm that has not modelled these in the engagement proposal has not planned for production. The ongoing cost of a well-built AI system is a knowable number – any firm serious about production deployment knows it and will share it. A practical rule: budget 20–40% above the quoted consulting fee to cover infrastructure, internal time, and post-launch support. A firm that has not shared this guidance unprompted is either inexperienced with production deployments or managing its quoted price appearance at your expense.

No knowledge transfer plan. If a consulting firm cannot describe specifically how your team will operate the system after the engagement closes, the firm is either planning a permanent dependency relationship or has not thought through the post-engagement operational reality. Both are problems.

References that are only available through the firm. As covered in our guide to how to choose an AI development company for enterprise projects, direct reference conversations with comparable client organisations are the most reliable signal of genuine production delivery capability. A firm that filters or controls all reference access is managing what you can discover.

How to Structure the Accountability Conversation from Day One

The enterprises that achieve consistent AI consulting ROI in 2026 are the ones that define accountability before the engagement starts, not after results disappoint.

The accountability conversation covers five specific commitments that should be documented in the engagement contract or statement of work:

Delivery milestones with acceptance criteria. Not just dates, but what will be delivered at each date, and what the criteria for acceptance are. “Staging deployment by week 8, meeting pre-agreed quality thresholds” is a milestone with acceptance criteria. “Development phase complete by week 8” is a date without accountability.

Quality thresholds are agreed upon before development begins. The specific metrics that will determine whether the system is ready for production. These must be agreed upon before development starts – not negotiated when the system is built and both parties’ incentives are misaligned.

Data quality risk provisions. What happens if the data quality discovered during the engagement is significantly worse than assumed in the proposal? Who bears the cost of data remediation? How does the timeline and budget adjust? A credible firm will address this explicitly rather than leaving it as an implicit client risk.

IP ownership and data handling. The client owns all code, configurations, and deliverables. No training on client data without explicit consent. Complete access to all systems and credentials from day one. Data deletion obligations at engagement end. These terms are not standard in all consulting contracts and must be explicitly negotiated.

Post-engagement support definition. What support is available after handover, for how long, with what response-time commitment, and at what cost? The absence of a defined post-engagement support arrangement is a practical signal about the firm’s confidence in the stability of what it delivered.

What a Good Engagement Looks Like for Moweb Clients

Rather than describing this abstractly, here is what working with Moweb on an enterprise AI consulting engagement specifically looks like – because you should be able to evaluate any firm against a concrete example, not just a generic framework.

Discovery phase (weeks 1 to 3): We conduct a structured data and use case assessment, including a data quality review of the specific datasets required for the proposed use case. We produce a written discovery report covering the use case definition, data assessment findings, technical architecture recommendation, pre-agreed quality thresholds, and a specific cost and timeline estimate for the development phase. If we cannot project a credible ROI pathway from the discovery findings, we say so at this stage – not six months later.

Development phase (weeks 4 to 14): We build for production from week one. Access controls, audit logging, monitoring, and governance are part of the initial architecture, not additions after the core system is working. We measure against the pre-agreed thresholds throughout development. We deploy to staging with real data by week 6 and production by week 12 to 14 for a standard first engagement.

Knowledge transfer (weeks 12 to 16): We produce complete technical documentation, operational runbooks, and conduct live training sessions with technical and business stakeholders. Our goal is that your team can operate the system independently after the engagement closes. We offer a defined post-engagement support arrangement for the first 90 days of independent operation.

Pricing transparency: We provide itemised cost estimates with clear scope definitions. We do not hide ongoing operational costs. We discuss ROI projection at the discovery stage, not as an afterthought.

Our AI Strategy & Consulting, Generative AI & LLM development, AI Agents & Intelligent Automation, and AI Platform Integration practices all operate within this engagement framework. Start with a conversation about your specific use case.

Frequently Asked Questions About Enterprise AI Consulting Engagements

How long does an enterprise AI consulting engagement take? A discovery and assessment engagement typically runs 3 weeks. A discovery-to-production engagement for a focused first use case typically runs 12 to 16 weeks. A multi-use-case programme spanning data engineering, first AI deployment, and CoE establishment typically runs 6 to 12 months. Timelines are heavily influenced by data readiness, integration complexity, and the organisation’s internal decision-making speed – the last factor is consistently underestimated as a timeline driver.

How do we know if a consulting firm has genuine AI production experience? Ask for a specific production deployment they can describe technically: the LLM and retrieval architecture used, the evaluation methodology and quality scores at deployment, what the system looks like six months after launch, and what went wrong and how it was addressed. Ask for a direct reference call with a client in a comparable industry. Ask to meet the engineers who will deliver your project before signing. See our guide to what American buyers expect from an enterprise AI partner for the full set of questions.

What is the typical ROI of an enterprise AI consulting engagement? McKinsey’s 2025 State of AI survey recorded a 5.8x average ROI on AI investment within 14 months for well-executed programmes   but also found that 73% of enterprise AI deployments fail to achieve projected ROI (McKinsey Global AI Survey, 2026). The defining characteristic of the 6% achieving transformative returns was not technology selection but organisational discipline: KPI tracking, workflow redesign, and senior leadership accountability. IBM’s 2025 research found organisations average a $3.50 return for every $1 invested in AI   achieved when measurement frameworks are established from the start. A credible consulting firm should be willing to project at least 3x ROI on engagement cost within 12 months for a well-scoped first deployment.

What should be in the contract for an enterprise AI consulting engagement? The contract must cover: delivery milestones with specific acceptance criteria; pre-agreed quality thresholds defined before development begins; IP ownership of all deliverables assigned to the client; data handling and processing obligations; data quality risk provisions; post-engagement support definition; and liability for AI-generated outputs. See our guide on how to choose an AI development company for enterprise projects for the full contract checklist.

Should we use a global consulting firm or a specialist AI firm? Global consulting firms (Accenture, Deloitte, McKinsey) bring board-level credibility, industry benchmarking, and enterprise change management capability, at $300 to $600 per hour and minimum engagements of $500,000 or more. Specialist AI firms bring deeper hands-on engineering execution and faster delivery at significantly lower cost, typically $80,000 to $200,000 for a first production deployment. Many enterprises use both: a global firm for strategic framing and a specialist firm for technical delivery. The choice should be driven by what you need – strategy or production software – not by brand familiarity.

What is the difference between an AI consulting engagement and an AI PoC? An AI PoC (proof of concept) validates that a specific AI approach works technically on your data and within your constraints. It is typically the first phase of a larger consulting engagement. A full consulting engagement takes the validated PoC through production deployment, integration, governance, and knowledge transfer – the phases that convert a working prototype into an operational business system. A consulting engagement that ends at PoC without a defined production pathway is selling you experimentation, not transformation.

Conclusion: An Engagement Is Worth What It Delivers, Not What It Costs

The enterprise AI consulting market in 2026 is mature enough that you can expect working production software, measurable ROI, and genuine accountability from a credible consulting partner. The fact that many engagements do not deliver these things is not a statement about what is possible – it is a statement about what happens when engagements are not structured for accountability from the start.

The framework in this guide gives you the tools to structure an accountable engagement from the first conversation: phased deliverables with specific acceptance criteria, quality thresholds agreed before development begins, red flags that end conversations early, and an ROI target that both parties commit to at the start.

AI consulting is not inherently risky. Engaging a firm without a defined accountability structure, Moweb’s consulting engagements are structured for accountability: written discovery reports within three weeks, production deployments by week 14, pre-agreed quality thresholds, complete knowledge transfer, and defined post-engagement support. We work with enterprises across the USA, UK, India, and East Africa across AI Strategy & Consulting, Generative AI & LLM development, AI Agents & Intelligent Automation, and Data Engineering & Foundations. Talk to us about your engagement.

Found this post insightful? Don’t forget to share it with your network!

Pic
Pic
Pic

Looking to Hire

Dedicated Developers?

  • Expertise & Certificed Resources
  • Flexible Pricing & Working Models
  • AI Enablement for Enterprises & SMEs
  • Expertise in Complex Enterprise Software
  • Strong Product Engineering Capabilities
  • 18 Years of Proven Delivery Exerience
  • 900+ Projects Delivered
  • ISO 27001:2022 Certified
  • CMMI Level 3 Compliant

Read More Articles

How to Build an AI Center of Excellence: Structure, Roles, and 90-Day Roadmap

How to Build an AI Center of Excellence: Structure, Roles, and 90-Day Roadmap

What is an AI Center of Excellence? An AI Center of Excellence (AI CoE) is a cross-functional organisational structure that...
Moweb Limited
By Moweb Limited
26 May 2026
Enterprise AI Integration: How to Connect AI Systems to Your Existing Technology Stack

Enterprise AI Integration: How to Connect AI Systems to Your Existing Technology Stack

What is enterprise AI integration?Enterprise AI integration is the process of connecting AI systems (LLMs, RAG knowledge assistants, predictive models,...
Moweb Limited
By Moweb Limited
23 May 2026
Data Engineering for AI: Building the Foundations Your Models Actually Need

Data Engineering for AI: Building the Foundations Your Models Actually Need

What is data engineering for AI, and why does it matter? Data engineering for AI is the discipline of building...
Moweb Limited
By Moweb Limited
21 May 2026

ISO 27001:2022 CMMI Level 3

Sarthak House, Swastik Cross Road,
C. G. Road, Ahmedabad - 380009

Sales: +91 971 299 2717

11 Blanche St, Secaucus, New Jersey (NJ) 07094
